    Home»Tech»California’s Ambitious $2.2B Ivanpah Solar Project Heads Toward Shutdown Amid Performance, Cost, and Environmental Concerns
    Tech

    California’s Ambitious $2.2B Ivanpah Solar Project Heads Toward Shutdown Amid Performance, Cost, and Environmental Concerns

    Updated:December 25, 20254 Mins Read
    Facebook Twitter Pinterest LinkedIn Tumblr Email

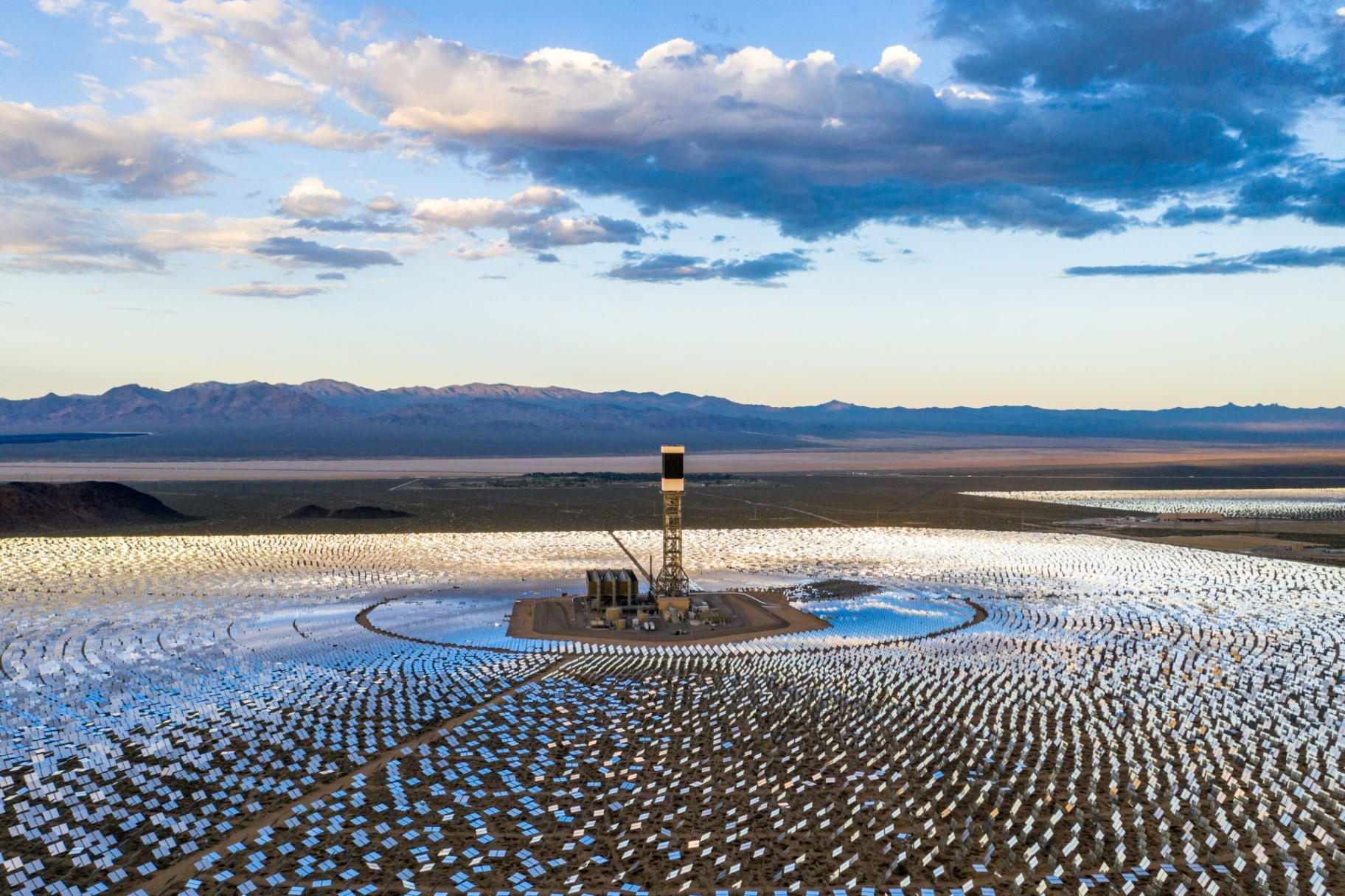

    California’s Ambitious $2.2B Ivanpah Solar Project Heads Toward Shutdown Amid Performance, Cost, and Environmental Concerns
    California’s Ambitious $2.2B Ivanpah Solar Project Heads Toward Shutdown Amid Performance, Cost, and Environmental Concerns
    Share
    Facebook Twitter LinkedIn Pinterest Email

    In a move that underscores the challenges of marrying ambitious clean energy goals with economic realism, the Ivanpah Solar Power Facility in California is being phased toward shutdown starting in 2026. The concentrated solar thermal plant—built with an estimated $2.2 billion in capital and backed by $1.6 billion in federal loan guarantees—has never lived up to its production expectations and has relied on natural gas backup. Pacific Gas & Electric (PG&E), one of its major off-takers, has already terminated its power purchase agreements early, citing expected savings for ratepayers. The facility also faced sharp criticism over environmental side effects—among them the death of thousands of birds each year due to extreme heat near its heliostat mirrors. Some of the plant’s owners and operators now plan to decommission two of its three towers, seek regulatory approval for the shutdown, and explore repurposing the land, potentially for more efficient photovoltaic projects.

    Sources: Sierra Daily News, AP News

    Key Takeaways

    – Ivanpah’s concentrated solar thermal technology underperformed relative to projections and never achieved full contracted output, prompting early contract termination by PG&E.

    – The project’s reliance on natural gas and environmental impacts—particularly bird mortalities around the concentrated mirror fields—have fueled critiques of its sustainability and justification.

    – Its impending shutdown highlights the shifting economics in solar energy, as lower-cost photovoltaic (PV) technology and battery storage have outpaced complex thermal solar systems in competitiveness.

    In-Depth

    Ivanpah Solar was launched with considerable fanfare as a bold experiment in large-scale concentrated solar power (CSP). Located in California’s Mojave Desert and composed of three tower units focusing sunlight via over 173,500 heliostat mirrors, it was once the world’s largest facility of its kind. Its construction—carrying a $2.2 billion price tag and backed by $1.6 billion in federal loan guarantees—was intended to mark a turning point in renewable energy technology. Yet just over a decade into its operation, Ivanpah has become a cautionary tale.

    From early days, the plant struggled to hit its energy output goals. Analysts found its actual electricity production lagged behind model predictions by significant margins, undermining the financial assumptions embedded in its design. One technical review of Ivanpah’s data showed the actual output for a tower was far lower than both hand-calculated estimates and models run by NREL’s SAM tool. This discrepancy drove up its levelized cost of electricity (LCOE), making it far less competitive than forecast. (Performance modeling and real-world comparisons from peer-reviewed sources highlight how underperformance inflated costs and eroded returns.)

    On top of that, Ivanpah depended on natural gas to augment or prime its operations—especially in mornings or during intermittent cloud cover. Though the facility was ostensibly solar, its auxiliary fossil fuel use was significant and controversial. That dual reliance diluted the narrative of a purely clean power source.

    Beyond the technical and economic underpinnings, environmental critiques gained traction. The plant’s intense mirror fields create extreme localized heat near the tower receivers, killing birds and occasionally bats that fly into the focal zone. Environmental groups have estimated annual bird deaths in the thousands. In addition, some ecological concerns were raised about the disrupted desert habitat and impacts on species such as the desert tortoise.

    Over time, changes in the solar market worked against Ivanpah. Photovoltaic (PV) panels, along with battery storage systems, have seen steep cost declines and scalability gains that CSP designs struggled to match. When PG&E re-evaluated long-term contracts, it concluded canceling its agreements would save ratepayers money. In early 2025, negotiations resulted in ending contracts on two of the three towers. Operators, including NRG, now plan to begin decommissioning those units in 2026, pending regulatory approvals. Some of the land may be repurposed for newer solar developments, likely PV.

    Ivanpah’s experience offers a few clear lessons. First, aggressive subsidies and engineering ambition do not guarantee commercial success—especially when assumptions diverge from operating reality. Second, technology choice matters: simpler, more modular solutions often carry less risk in evolving markets. Third, planning for eventual decommissioning and environmental remediation is essential, especially for large infrastructure projects. Ultimately, Ivanpah may be remembered less as a clean energy triumph and more as a high-stakes experiment whose failures will inform the next generation of solar.
